June 25, 2026
This work investigates the impact of reconfigurable intelligent surfaces (RIS) on radio links other than the one for which the RIS configuration is optimized. We consider three different scenarios in which a secondary communication link could be affected by a RIS whose configuration is optimized for a primary communication link operating in the vicinity, on the same or on different frequencies. This question is investigated experimentally in the FR1 band, using the CorteXlab radio testbed and a Greenerwave RIS. We show that the impact, in terms of received power and impact on the channel phase of the secondary link, is significant even outside of the nominal frequency range of the RIS, and is not mitigated by carrier frequency separation between the two communication links.
RIS is one of the key technologies touted for the 6G of cellular communications, due to its capability to improve coverage by actively overcoming shadowed areas through reflected beam steering to and from a UE and a BS. It is accomplished by modifying the RIS’s array of reflector elements reflectivity pattern [1], [2]. This reflectivity pattern is typically chosen to optimize a performance metric relevant to network operation.
Many works have concentrated on the positive impacts of RIS, such as [1]–[3] and references therein. A considerably smaller body of work deals with the potential drawbacks of RIS. The work in [4] introduces the problem of operators coexistence when a RIS is involved; it discusses the BoI of a single RIS element. More recently, [5], tackled the coexistence problem consisting in mitigating the spurious reflections from a RIS in a non-cooperating scenario, while [6] evaluates the impact of uncoordinated RIS in the uplink on the interference between different networks. [7] introduced an analytical model for coexistence between two networks subject to a RIS and proposed two solutions: a multilayered RIS with out-of-band filtering capabilities and a RIS radio blocking system that relies on angle separation to perform RIS-enabled interference cancellation to secondary receivers. In [8], the authors have studied the effects of surrounding and uncontrolled EMI on ongoing communications using a RIS to enhance communications SNR. FSS [9] are another possible solution to the coexistence issue; by selectively transmitting or reflecting electromagnetic waves in a specific frequency range, they can help limit the secondary wideband effect of RIS.
In this work, we aim to contribute to the analysis of the potentially deleterious effects of RIS from an experimental point-of-view by measuring its effects of co-channel and adjacent channel communications. Unlike [5], [7], [8], we provide actual radio measurements to support an insightful and comprehensive analysis of coexistence in three cases: 1) the impact when an operator deploys a RIS device, to other nearby users of the same operator (operating on the same frequency band), 2) the potential impact on nearby users of coexisting operators, and 3) the impact of a RIS optimized for one band to signals transmitted to the same user on another band.
This paper is organized as follows. Section 2 details the cases studied in which the adoption of a RIS device can be nefarious to nearby users. We present our measurement scenario in section 3. A comprehensive analysis of the measurements, explaining our metrics is given in section 4. We present and discuss the findings in section 5, and finally draw conclusions and discuss possible solutions in section 6.
Figure 1: Scenarios in which a RIS can negatively impact the communication performance of the secondary link. a — TDMA scenario., b — Multiple Operators Scenario., c — Multiband Scenario.
In this work, we will consider a primary link, between TX\(_1\) and RX\(_1\) operating at frequency \(f_1\), for which the RIS parameters are being optimized, as well as a secondary communication link, between TX\(_2\) and RX\(_2\), operating in parallel to the primary link. The assumption is that the secondary system is affected by the RIS, however not necessarily in the most favorable way since the RIS is optimized for the primary system. In fact, in many deployment cases, the primary and secondary system may not even be aware of the presence of each other, for instance in the case of two cellular operators using adjacent carriers. We want to understand the consequences of the RIS usage from the primary link over the secondary link, both in terms of power gain/loss (a metric commonly considered to evaluate positive RIS effects in the literature) and in terms of the sudden changes in channel phase due to changes in the RIS configuration. Changes in channel phase may have little or no impact on the received power, but can be harmful to coherent transmission schemes or beamforming strategies. These metrics are detailed in Section 4. Our study is structured around three representative scenarios, which are detailed next.
The scenario involves the primary and secondary communication links sharing a same frequency (\(f_1 = f_2\)), with TX\(_1\) and TX\(_2\) co-located, as depicted in Figure 1 (a). This may happen in the case where two or more users of the same network operator, communicating with the same base station, are scheduled alternatively over the same frequency (or resource block, as in modern OFDM-based networks with dynamic resource block allocation). We assume that the RIS is optimized for RX\(_1\) only (for instance due to the limited overhead dedicated to RIS control), even when the intended user is RX\(_2\). We hence evaluate the impact on RX\(_2\) of a RIS configuration which has been optimized for another user in the network, operating on the same frequency.
This scenario corresponds to the case where two networks operate independently on distinct frequency bands (\(f_1 \neq f_2\)) in a shared geographical area, as depicted in Figure 1 (b). Such a scenario is often encountered when different operators are allocated distinct frequency ranges in the same frequency band, with typical separation between center frequencies ranging from dozens to hundreds of MHz. We assume that the RIS is optimized for the primary link, and that there is no coordination with the secondary operator. We evaluate the impact of the RIS controlled by first operator to optimize the TX\(_1\)-RX\(_1\) link on the operation of the TX\(_2\)-RX\(_2\) link. Note that it is sometimes assumed that the effect of a RIS can be limited to a band of interest, and that its impact on adjacent bands will be negligible; however we will see that this assumption is disproven by our experiments.
The last scenario, depicted in Figure 1 (c), involves a single transmitter and a single receiver, however the communication is performed on two distinct frequency bands, with primary and secondary links on
frequencies \(f_1\) and \(f_2\) respectively; the RIS is configured to enhance the quality of the link on frequency
\(f_1\) only. Note that the lack of channel reciprocity over distinct frequencies implies that optimizing on frequency \(f_1\) is not necessarily favorable for frequency \(f_2\). This case may arise due to FDD uplink-downlink switching, or in systems using multi-band carrier aggregation or frequency hopping. Hence, in this
scenario, we evaluate the impact of using a RIS optimized for the correct TX and RX locations but for an incorrect frequency.
For all of the above three scenarios, solutions to mitigate the deleterious effect of the RIS on the secondary system exist and can be implemented with varying degrees of technical complexity. In the TDMA and multiband scenarios, mitigation through RIS re-configuration is possible since the (single) TX is aware of the radio parameters of all links (primary and
secondary); however there may be cases where this reconfiguration is not desirable or impossible, e.g. to limit signaling overhead or because RX\(_2\)
is not in a connected state. For the multi-operator scenario, the situation is more complicated since coordination between several operators, potentially using hardware from different vendors, would be technically complex. Thus, we believe that the
proposed experimental assessment is of interest as it can motivate the necessity of policies to guide coordination in the use of time, frequency and spatial resources. This study may also highlight problems concerning the usage of autonomous RIS devices [10].
CorteXlab is a physical-layer-centric radio testbed composed of 40 SDR nodes, composed of a mix of SISO and MIMO nodes, with synchronization infrastructure to provide time and frequency synchronization across radios and hosted in an electromagnetically isolated room of approximately 160 m\(^2\). It allows for stable radio propagation and reproducible experiments since it does not suffer interference from the outside. Table 1 provides the important features of CorteXlab.
| Room dimensions | 18 m \(\times\) 9 m |
|---|---|
| no reflections on walls | |
| Propagation details | only reflections off floor, |
| and hardware on ceiling | |
| Antennas | log periodic AARONIA 70600 |
| Antenna grid layout | every 1.8 m, in two dimensions |
| Antenna height from floor | 1.65 m |
Measurements were carried out inside of CorteXlab using a RIS device targeting the FR1 band [11]. Its main characteristics are summarized in table 2.
| Operating frequency range | 3.3-4.1GHz (FR1) |
|---|---|
| Panel dimensions | 40 cm \(\times\) 40 cm |
| Number of elements | 128 |
| Number of states per element | 2 (on-off) |
| Polarization | H-pol and V-pol |
| Scan Range (Azimuth, Elevation) | +/- 60° |
| RF Power Dissipation at Reflection | max 1.5dB, average 1dB |
| RF Power Handling | 50W |
| Average Power Consumption | \(\leq\) 0.2W |

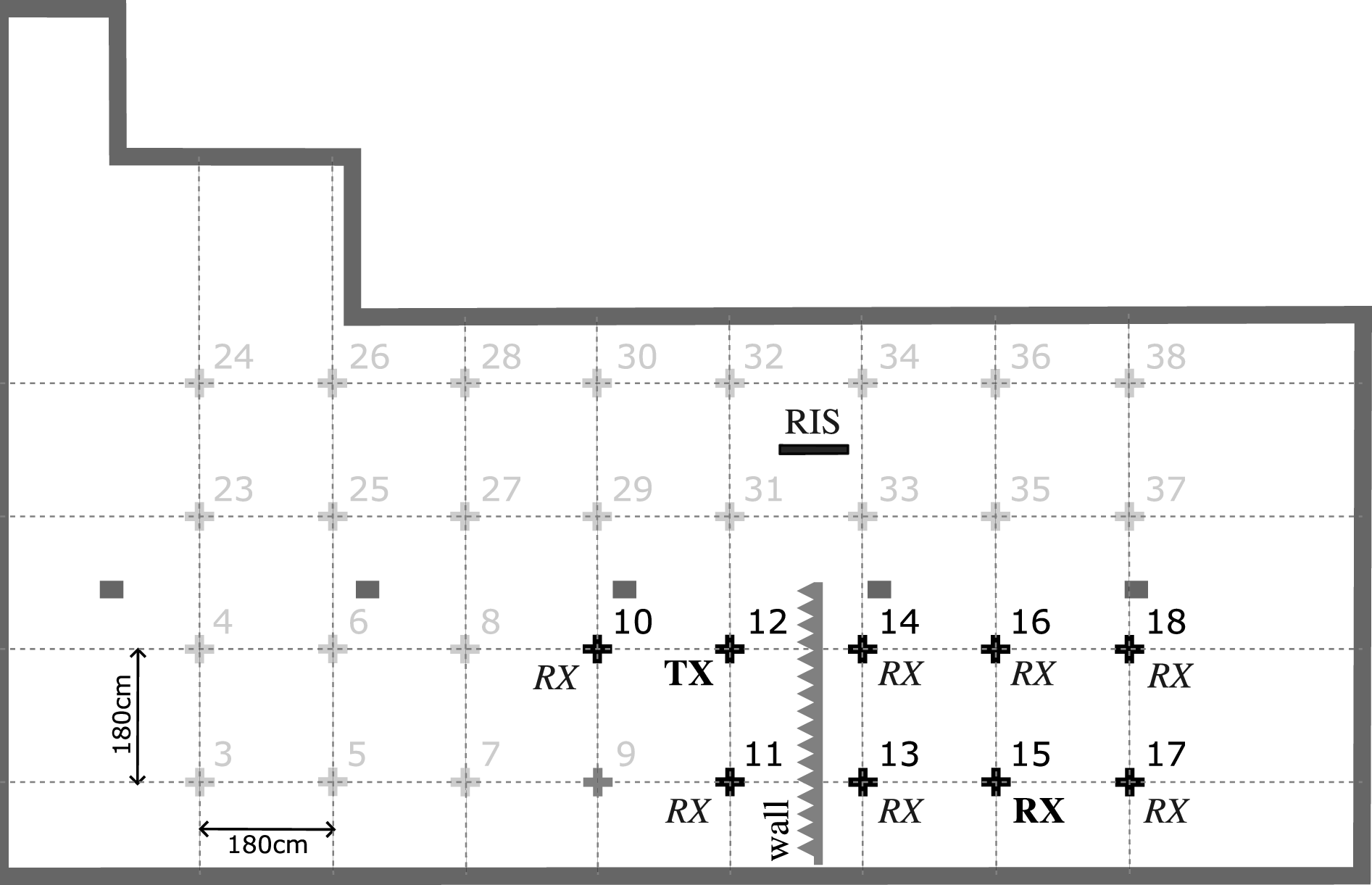

To reproduce a configuration where using a RIS would be relevant, a temporary wall covered with aluminum and RF absorbing foam panels is placed in the room, blocking LoS communication between groups of nodes 10-11-12 and 13-14-15-16-17. The RIS is installed in-line with this wall
so as to be in LoS of both groups of nodes (see Fig. 2). A TX is
active on one side of the wall (node 12), with most of the RXs (nodes 13 to 18) shadowed by the wall. To provide comparison points, two RXs are also set next to the TX (nodes 10 and 11).
The channel sounding system operates as follows: All radio devices are synchronized in time and frequency using 10MHz and PPS signals from a common Octoclock device, ensuring a common carrier frequency and sampling time and rate. The active transmitter
emits a continuously repeating sequence obtained as the inverse DFT of the Zadoff-Chu sequence of length 255 and root index 1 at a rate of \(5.10^6\)
samples per second. The received sequences are integrated four times, to increase SNR and reduce computation loads, before going through a DFT. Symbol-wise division by the original sequence yields the frequency-domain channel responses, sampled in 255 bins spanning 5 MHz. Measurements proceed according to two phases, namely (i) RIS configuration and
(ii) measurements collection.
During phase (i), the RIS configuration is optimized to maximize the average power (in dB) for the primary link (TX\(_1\)-RX\(_1\)), measured in the middle 1 MHz of the transmission band and excluding the bin at DC (0 Hz). A codebook of RIS configurations is constructed by optimizing the RIS parameters using the algorithm described in [12] for different values of \(f_1\) and for different target receivers; the objective is to be able to randomize the RIS configuration in a way that ensures that all states in the codebook correspond to a reasonable operating state for the primary link (it is optimal for some choice of a RX\(_1\) node and frequency \(f_1\)). The codebook is constructed by letting \(f_1\) span frequencies ranging from 2.5 GHz to 4.4 GHz in 20 MHz steps, for each target RX. During phase (ii), another sweep is performed, over the same frequency range and step size for \(f_2\). At each step, all configurations in the codebook are recalled successively, and for each, the entire complex frequency response is recorded at all receivers, along with a reference measurement with the RIS in its default (off) state.
Figure 3: TDMA Scenario, \(f_1 = f_2\), \(1\) MHz steps. For all plots, RX\(_1\) = 15. Green shade is nominal RIS operation bandwidth. a — Gains, b — EVM
Figure 4: Multiple Operators Scenario, distribution over all \(RX_1 \neq RX_2\) and all \(f_1 \neq f_2\), \(2.5~\text{GHz} \leq f_1 \leq 4.4~\text{GHz}\), in \(100\) MHz steps (bars denote 1% and 5% percentiles).. a — Gains, b — EVM
The gathered dataset contains channel frequency response vectors for all the combinations of \(f_1\), \(f_2\), \(RX_1\), and \(RX_2\). Two metrics are extracted from this data, and interpreted according to the three different scenarios described in Section 2.
Power at RX\(_2\) is averaged as described above over a 1 MHz band centered on \(f_2\), and compared with the corresponding power of the reference (RIS off) measurement at the same \(f_2\), measuring the RIS impact on the received power.
This models a situation where where the RIS configuration changes during the transmission of a data frame. We assume a worst-case scenario where the channel gain \(\mathbf{h} \in \mathbb{C}\) on the secondary link is estimated from a pilot sequence (e.g. demodulation reference symbols, DMRS), immediately followed by a RIS re-configuration so that the subsequent data symbols experience a different channel \(\mathbf{h}' \neq \mathbf{h}\). At high SNR, a zero-forcing equalizer would multiply the received baseband samples with \(\mathbf{h}^{-1}\) to produce data symbol estimates, resulting in a mismatched equivalent gain \(\mathbf{h}^{-1}\cdot\mathbf{h}'\) which is in general different from 1 due to the RIS reconfiguration. We evaluate this deviation in terms of the resulting EVM, defined as \(\mathrm{EVM} = \left| \mathbf{h}^{-1} \cdot \mathbf{h}' -1 \right|\).

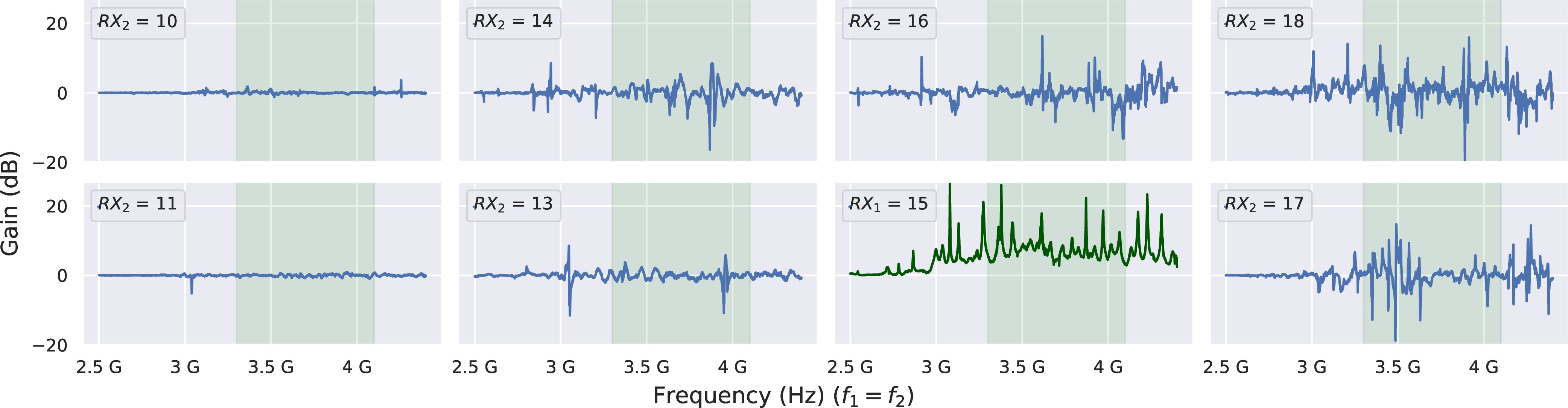

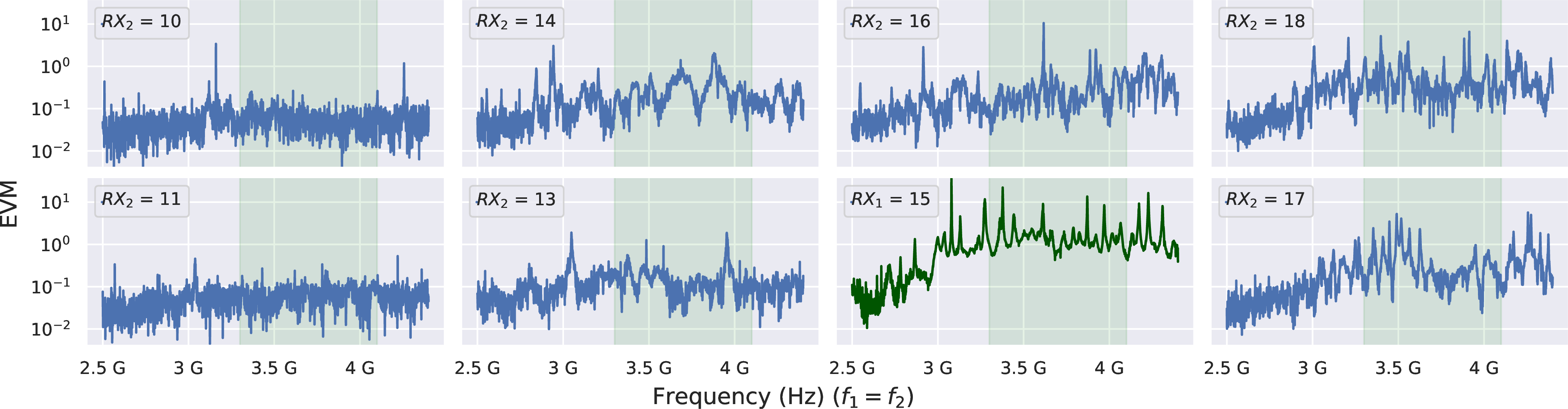

The first set of results corresponds to the TDMA scenario (\(f_1=f_2\)) described in Section 2.1 with RX\(_1\) chosen as node 15. Power gain and EVM metrics are presented in Figs. 3 (a) and 3 (b) respectively. Subplots positions for different choices of RX\(_2\) are arranged to correspond approximately to the real spatial distribution of RXs shown in Figure 2. Looking at the subplot for RX\(_1=15\) in Fig. 3 (a), the primary user benefits from more than 5 dB of gain across the band starting from \(\sim\)3 GHz and up to the highest measured frequency, and reaches up to 20 dB at specific frequencies. This validates the expected behavior of the RIS, which was designed to operate between the 3.3 and 4.1 GHz (RIS’s nominal frequency range, depicted by a green shade on the figures) and has no effect for frequencies below \(\sim\)3 GHz. The frequencies where a high gain (i.e., above 10 dB) is achieved correspond to frequencies where the user would suffer from deep fading without the RIS. We should note, however, that the RIS provides consistent gains all over the target frequency range. As for EVM, as seen in Fig. 3 (b), we see that the primary user’s channel suffers from a high phase mismatch throughout the intended frequency range of the RIS. This is seen for EVM values averaging around 1 in the range, and peaking above 10 for some frequencies. This behavior is not harmful to the primary user’s communications since it can estimate the channel and use proper equalization to correct for these distortions. This high EVM is expected since the optimization algorithm the RIS uses focuses on gain rather than channel response.
For the other RX\(_2\), two cases can be distinguished. Nodes 10 and 11 are within direct LoS of the transmitter. As expected, these two RXs see minimal gain and EVM impact from the RIS, especially since the RIS is optimized for a node on the other side of the separating wall. The EVM in particular remains quite low, with the exception of a few peaks above 1 at certain frequencies. On the other hand, when RX\(_2\) is one of nodes 13, 14, 16, 17 or 18 (for which the TX-RX\(_2\) link is blocked by the wall), with the RIS still configured to optimize the primary link between TX and RX\(_1\) (node 15), the effect is more pronounced, with positive gains up to 15 and negative gains up to -20 dB, depending on the frequency. These results highlight a frequency selectivity induced by the RIS for masked nodes. As for the EVM (Fig. 3 (b)), significant channel perturbation is incurred by the secondary link, with different behaviors depending on the secondary RX position.

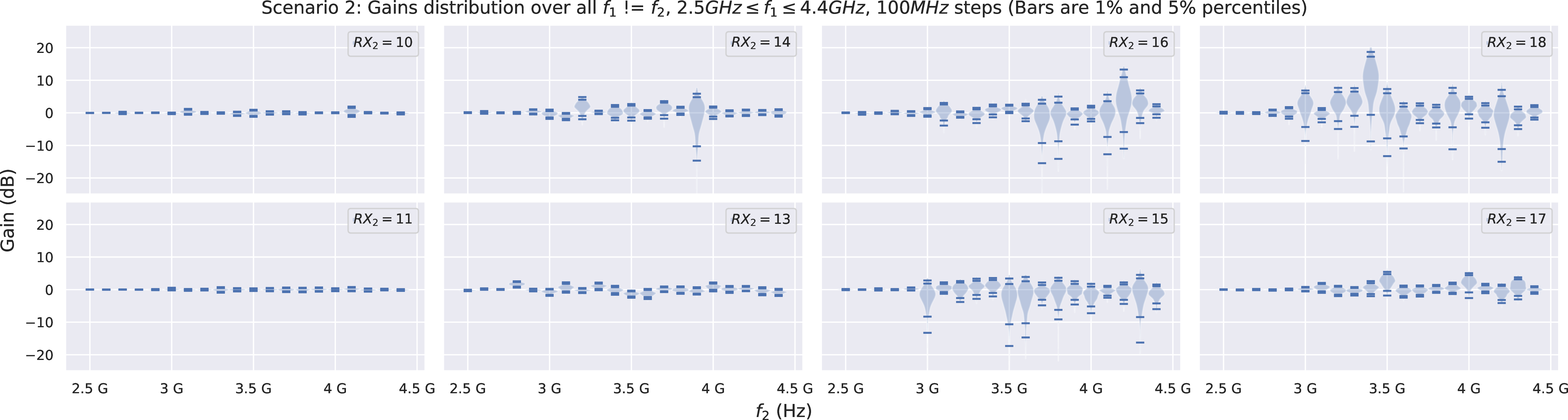

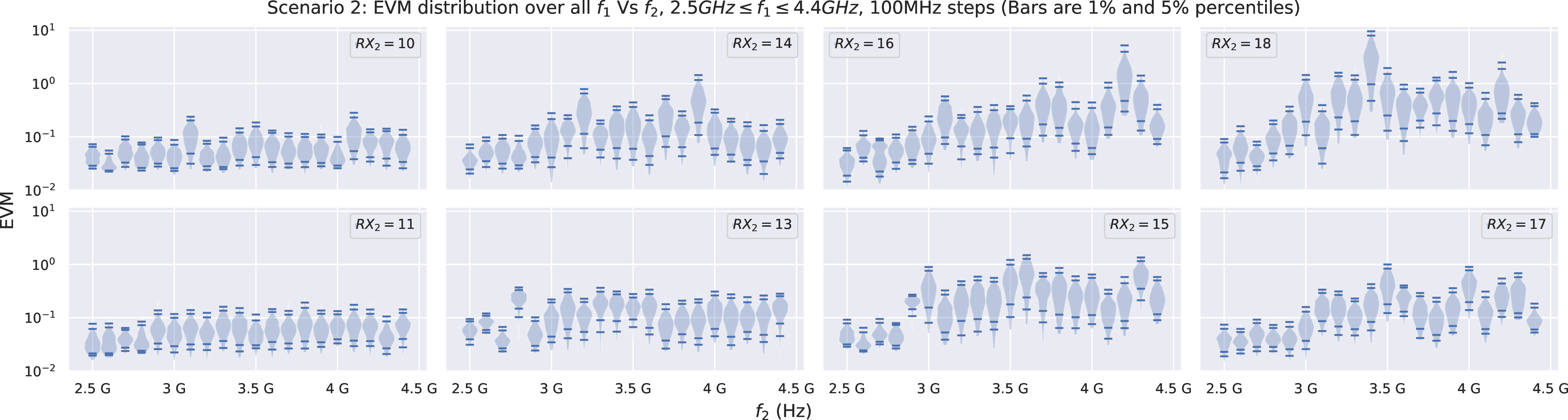

The second set of results corresponds to the scenario described in Section 2.2, where the effect on the secondary link is measured for each choice of \(RX_2\) and \(f_2\), where \(RX_1 \neq RX_2\) and \(f_1 \neq f_2\). Results are depicted on Figs. 4 (a) (gains) and 4 (b) (EVM). As in the previous scenario, the two secondary RXs with LoS to the transmitter, i.e. nodes 10 and 11, both see minimal impact due to the RIS. When RX\(_2\) is one of nodes 13, 14, 16, 17 or 18, the effect of the RIS reconfiguration is noticeable for frequencies \(f_2\) above 3 GHz approximately. In most frequencies, the gain distribution is centered around 0 dB but in some, this center is offset by 5 or even 10 dB. These correspond to frequencies \(f_2\) where the \(RX_2\) suffers from deep fading in the absence of RIS; in that situation, it is more likely that a RIS configuration improves the received power than degrades it. In contrast, in some cases, the distribution, though centered around 0 dB, shows a long tail towards negative gains. At these frequencies, the channel is prone to disturbances from the RIS. Both cases exhibit a correspondingly high EVM. We note that even at frequencies where the impact in terms of power gain/loss remains low, the EVM distributions are centered above .1 in most cases, which can be sufficient to create significant equalization mismatch.
Figure 5: Multiband Scenario, Metrics over all \(f_1\) vs. \(f_2\), RX\(_1\) = RX\(_2\). a — Gains, b — EVM

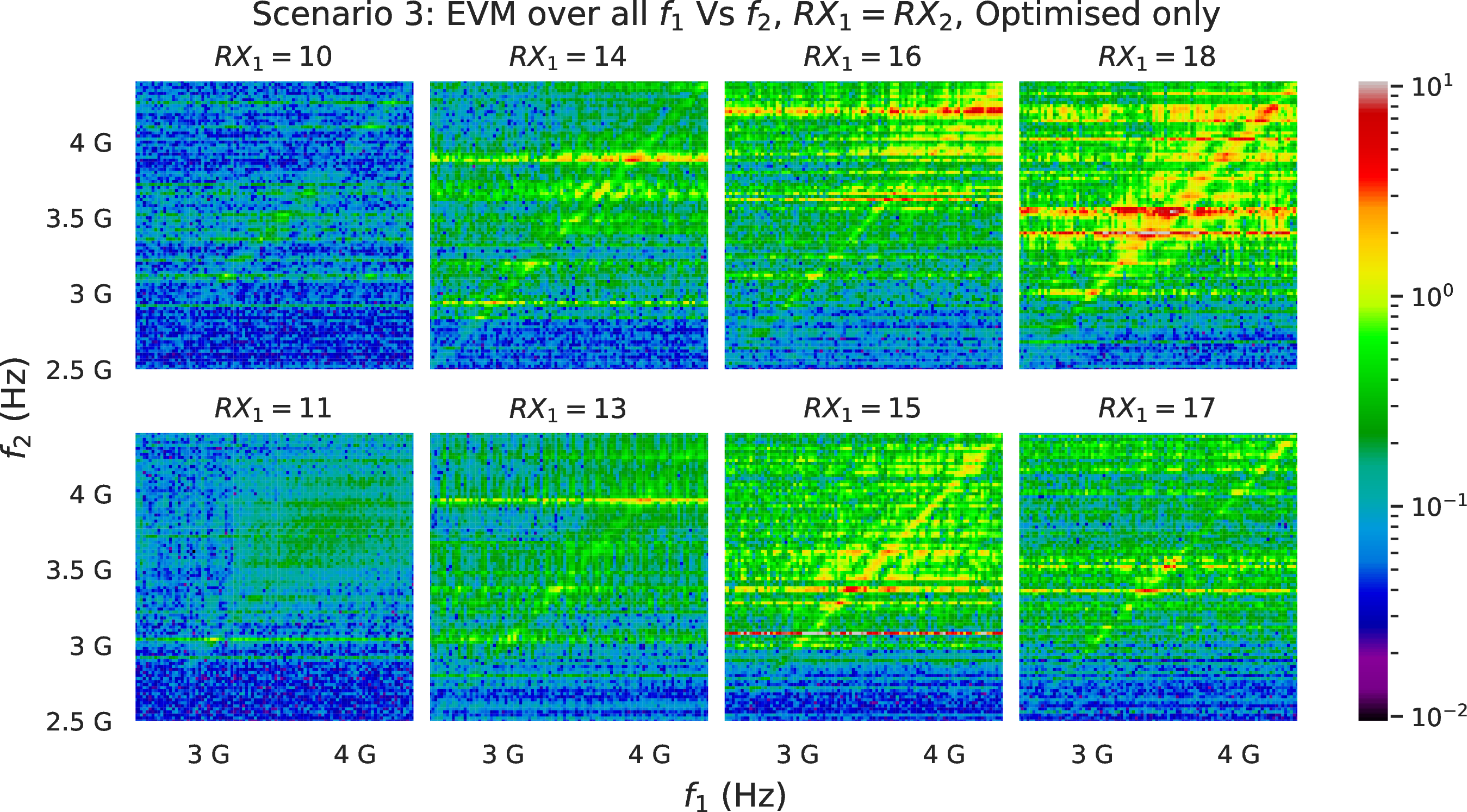

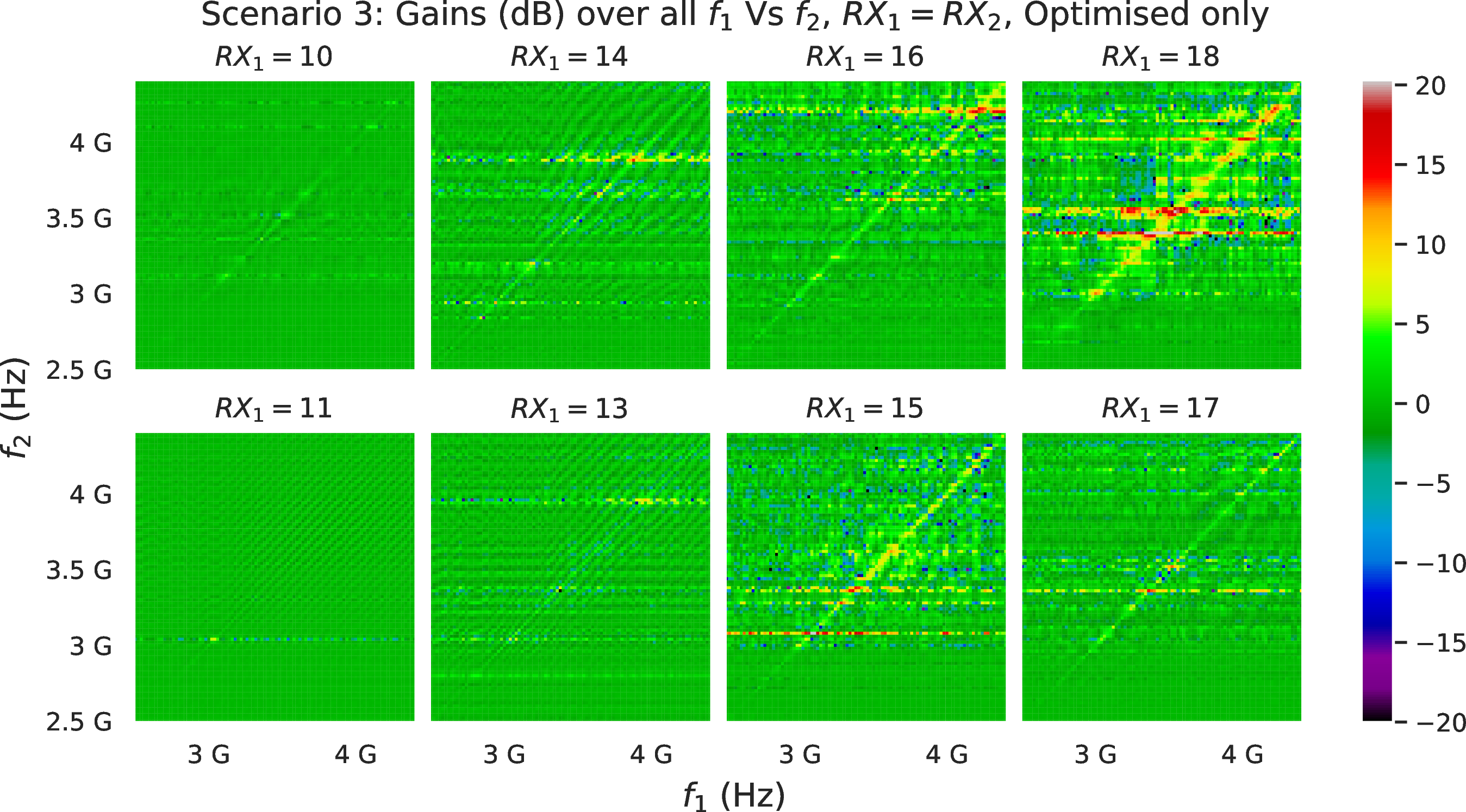

The last set of results, depicted in Fig.5, corresponds to the scenario described in Section 2.3 where we consider all combinations of \(f_1\) and \(f_2\) for cases where \(TX_1 = TX_2\) and \(RX_1 = RX_2\). The diagonal on all plots corresponds to cases where \(f_1 = f_2\) (primary and secondary systems coincide), showing the intended effect of the RIS. Again, receivers with LoS (i.e. nodes 10 and 11) and frequencies below \(\sim 3~GHz\) incur minimal impact from the RIS. High gain areas, which show as horizontal lines in Figs. 5 (a), correspond to frequencies \(f_2\) where the secondary link is in deep fades and is likely to benefit from a random RIS configuration. Diagonal ripples can be seen in both Gain and EVM metrics around the main diagonal line, alternating between higher and lower impacts with different periods depending on the receiver between \(\sim80\) MHz for RX 11 and 13, and \(\sim300\) MHz for RX 18. As in the previous scenario, the EVM is above .1, and even above 1 in large parts of the measured spectrum, with green and yellow dominating plots for receivers without LoS (RX\(_2 \in \{13, 14, 16, 17, 18\}\)). Even for \(RX_2 = 11\) that has barely any visible power gain impact, a patch of EVM higher than 0.2 can be seen with \(f_1\) and \(f_2\) around \(\sim3.75\) GHz, illustrating that even channel phase shifts yielding small changes in the received power can significantly degrade transmission quality.
We have evaluated experimentally the impact of a RIS on radio links other than the one for which the RIS configuration is optimized, in the FR1 band. Our measurements show that the impact on the secondary link, in terms of received power and EVM due to mismatched equalization, is significant even outside of the nominal frequency range of the RIS, and is not mitigated by carrier frequency separation between the primary and secondary communication links.
This work was supported by the European Commission under Horizon Europe SNS project INSTINCT (grant 101139161). Measurements presented in this work were carried out using , a precursor infrastructure of SLICES-RI (see http://wiki.cortexlab.fr and https://www.slices-ri.eu). The RIS device was kindly provided by Greenerwave.↩︎
